Power Is the Next Bottleneck After Nvidia, Part 3: Transformers and Transmission, the Companies That Carry Electricity to the Data Center

Why transformers are scarce and what HD Hyundai Electric, Hyosung Heavy, LS ELECTRIC and cable makers supply the US grid, with lead times, backlogs and tariffs.

On this page

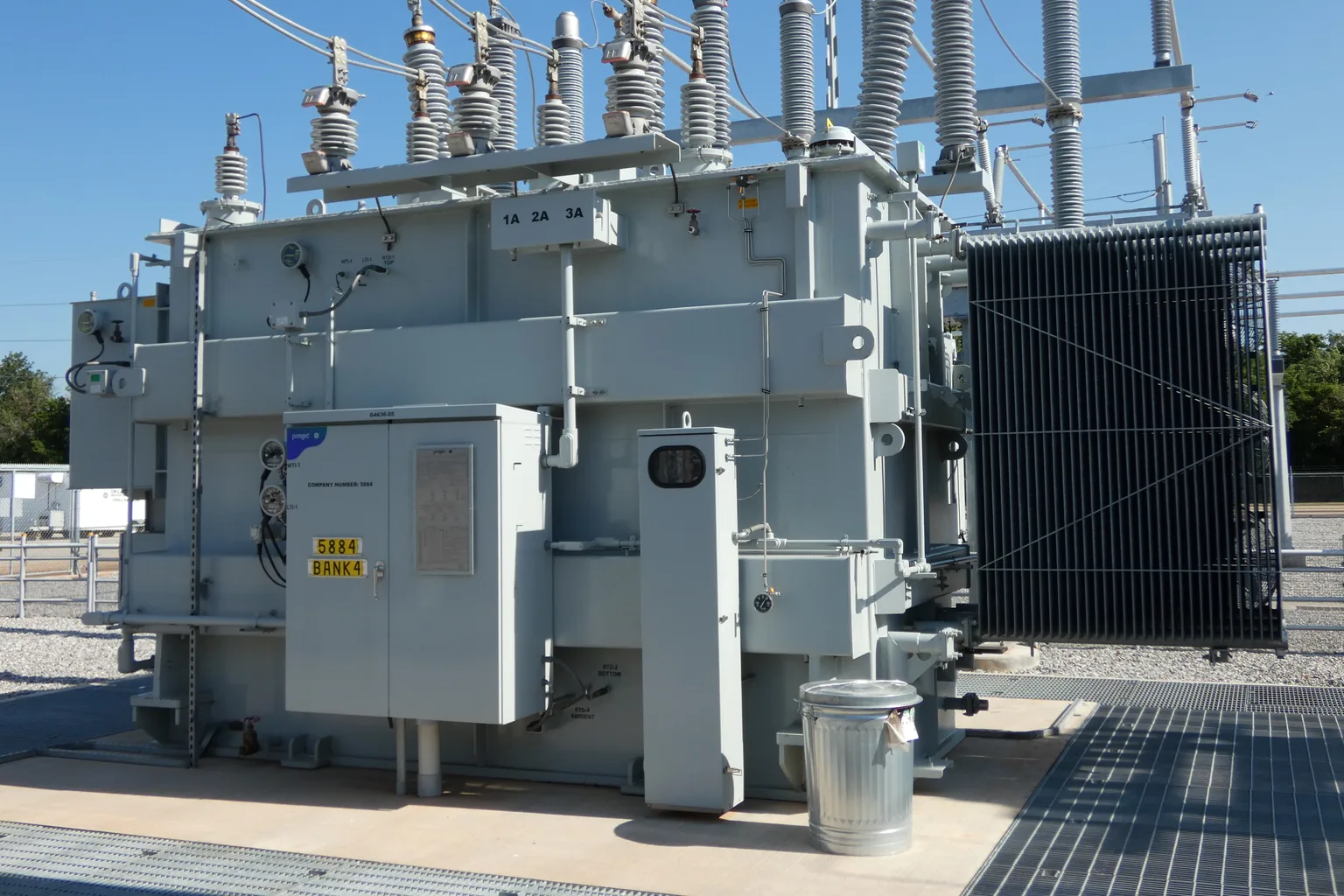

A power transformer at a US substation that steps 138 kV down to 12.5 kV. High-voltage lines enter through the bushings on top and the radiators on the right cool the unit

Photo: Yoshieslunchbox, CC BY-SA 4.0, via Wikimedia Commons, cropped

Transmission is the stage that carries electricity from a power plant to consumers hundreds of kilometers away at high voltage. Substations are the stage that converts that voltage to a usable level. The key equipment at both stages is the transformer. However fast a power plant is built, electricity will not reach a data center without transformers and transmission lines.

This is also the stage where Korean companies drew the most attention in AI power investing. HD Hyundai Electric, Hyosung Heavy Industries and LS ELECTRIC were called beneficiaries of the US transformer shortage. Their shares rose several dozen times from early 2023 and then corrected sharply after a May 2026 peak. These companies are global suppliers to the US grid, so they stay in this series. Part 3 uses primary-source figures to show why transformers are scarce, what the three companies and their overseas competitors make and how large their order books are, and how tariffs and cable and transmission investment fit in.

Power Is the Next Bottleneck After Nvidia series. Part 1: Why power is AI's bottleneck · Part 2: Generation (gas turbines, nuclear) · Part 3: Transformers, transmission, cables · Part 4: Distribution, data-center power, storage · Part 5: Is power a better investment than chips?

What Transmission and Substations Do: Raise the Voltage, Then Step It Down in Stages

The higher the voltage, the less electricity is lost over a long distance. So a power plant raises its output to several hundred thousand volts for the transmission line, and substations near the point of use step it down in stages before it goes to factories, buildings and data centers. The equipment that raises and lowers voltage is the transformer, and each stage needs a transformer of a different size and purpose.

TypeLocation and roleCharacteristicsMain companies
Step-up transformer (GSU)At the power plant, raises generator output to transmission voltageNeeded at every plant, longest lead timesHitachi Energy, Siemens Energy, HD Hyundai Electric, Hyosung Heavy Industries
Extra-high-voltage large power transformer (LPT)At transmission substations, changes voltage (100 MVA or more, 150-400 tons)Custom-built, mostly imported in the USHD Hyundai Electric, Hyosung Heavy Industries, LS ELECTRIC, Hitachi Energy, GE Vernova (Prolec GE)
Distribution transformerOn utility poles or pads, the last voltage step-downSmall, mass-produced, aging installed base in the USEaton, LS ELECTRIC, Prolec GE and others

Definitions: US Department of Energy (DOE), "Large Power Transformer Resilience Report" (Jul 2024)

When a single data center draws several hundred MW, a dedicated substation often has to be built nearby. This is why the Part 1 lead photo shows a large substation right in front of the data center buildings.

Voltage raised at the power plant stepping down through a substation and a distribution transformer before entering a building. Each stage needs a different transformer, and the largest extra-high-voltage units are the hardest to obtain

Why Transformers Are Scarce: Custom Orders, Import Reliance and Aging Replacements Overlap

Extra-high-voltage transformers differ in specification from grid to grid, so each is built to order. In a July 2024 report to Congress, the DOE wrote that large transformers that could be delivered within a year before the pandemic now have "36-month lead times common and up to 60 months." In Wood Mackenzie's Q2 2025 survey, lead times averaged 128 weeks for power transformers and 144 weeks for step-up transformers (POWER, Jan 2, 2026).

Prices rose sharply as well. In the same survey, power transformer prices were up 77% and step-up transformer prices up 45% from 2019, and the US shortfall in power transformer supply was estimated at about 30% in 2025. Wood Mackenzie said "long lead times and high costs will become the new normal."

The US has a particular problem with import reliance. According to a US Department of Commerce estimate, 617 of the 754 large transformers installed in the US in 2019 (82%) were imported. About 80% of grain-oriented electrical steel, the key material, was also imported, and US transformer makers bought it mainly from Japan and Korea. On top of that came the replacement cycle for transformers installed around 2000, plus demand from data centers and manufacturing.

Not everyone sees a "shortage," though. In the same POWER article, the head of a US electrical equipment company said "there is no shortage" and that his firm can deliver 12 to 14 months after drawing approval. The degree of shortage depends on the transformer type and the customer's contracting method, and some assessments say distribution transformer supply improved in 2025.

HD Hyundai Electric: The Company That Took the Most North American Transformer Demand

HD Hyundai Electric makes power equipment such as extra-high-voltage transformers, distribution equipment such as switchgear and breakers, and rotating machines such as motors and generators. Its sales and orders center on North American power transformers, and North America accounted for 65.8% of its $6.731 billion backlog at the end of 2025.

Earnings have set a record for five straight years since 2021.

PeriodRevenueOperating profitOperating marginBacklog
Full year 2025KRW 4.0795 trillion (+22.8%)KRW 995.3 billion (+48.8%)24.4%$6.731 billion
Q1 2026KRW 1.0365 trillion (+2.1%)KRW 258.3 billion (+18.4%)24.9%$7.888 billion
Q2 2026KRW 1.1418 trillion (+26%)KRW 287.0 billion (+37.3%)25.1%$8.490 billion

Source: Dealsite (Feb 6, 2026), Hankyung (Apr 28, 2026), Asia Economy and Dailian (Jul 28, 2026). Changes are year over year

It is also expanding US production. It is spending about $200 million on a second plant next to its Montgomery, Alabama facility. When finished, extra-high-voltage transformer output rises 50% and the site gains 765 kV transformer production and testing capacity. The completion target is April 2027 (Korea Times, Mar 8, 2026). 765 kV is the highest transmission voltage in the US, and a September 2025 contract with the largest Texas utility for 24 765 kV transformers and reactors, worth about KRW 277.8 billion, was the largest single contract in the company's history.

Chart data

Chart summary: HD Hyundai Electric (267260) daily candles, 2024-01-02 to 2026-10-12. Close 80,100 KRW → 582,000 KRW (+626.6%); period high 1,430,000 (2026-05-07), low 79,400 (2024-01-02). Marked: Post-holiday dip 2025-01-31 close 410,000, Closing high 2026-05-07 close 1,420,000, Day after Q2 2026-07-29 close 586,000.

The share price moved far more than earnings. It rose about 35 times, from a KRW 40,450 close on January 2, 2023 to KRW 1.42 million on May 7, 2026, and on October 12, 2026 it traded in the high KRW 500,000s, about 59% below the peak. Even the day after it reported a 37% rise in Q2 operating profit (July 29), the stock dropped 17% in a day. It shows that even good results can send a stock sharply lower if they fall short of expectations that have already risen.

Hyosung Heavy Industries: The Largest Supplier of US 765 kV Transformers

Hyosung Heavy Industries' heavy industry segment makes extra-high-voltage transformers, gas-insulated switchgear (GIS) and breakers, and HVDC and static synchronous compensator (STATCOM) equipment. Its US base is the Memphis, Tennessee transformer plant it bought from Mitsubishi Electric in 2020 for $46.5 million. The company says it ranks first in cumulative installations of 765 kV transformers in North America and has supplied nearly half of the 765 kV transformers in the US.

Earnings and orders grew later and more steeply than at HD Hyundai Electric. In 2025, revenue was KRW 5.9685 trillion (+21.9%) and operating profit KRW 747.0 billion (+106%), both records. In Q2 2026, it posted revenue of KRW 1.687 trillion and operating profit of KRW 264.3 billion (+60.9%), and first-half orders of KRW 7.4981 trillion nearly matched all of 2025's orders. The backlog is KRW 17.5 trillion, up 63% from a year earlier, and the company raised its 2026 order target from KRW 8.4 trillion to KRW 12 trillion (Dailian, Jul 31, 2026).

In February 2026, it signed a KRW 787.0 billion contract with a major US transmission operator for 765 kV transformers and reactors, its largest order ever. It is expanding the Memphis plant with another $157 million and plans to run it at full capacity from 2028 (Hankyung, Aug 3, 2026).

LS ELECTRIC: Transformers Are a Fast-Growing Second Business

LS ELECTRIC's main business is the switchgear and breakers covered in Part 4, but it is also growing its extra-high-voltage transformer business quickly. In Q2 2026, extra-high-voltage transformer revenue was KRW 158.1 billion, up 91.2% from a year earlier, while company revenue was KRW 1.577 trillion (+32.2%) and operating profit KRW 178.5 billion (+64.4%) (SBS Biz, Jul 23, 2026).

Its production base is Busan. It completed a second Busan extra-high-voltage transformer plant in December 2025 at a cost of KRW 100.8 billion, and in the US it makes switchgear and transformers together at its Bastrop, Texas campus. Transformers are the smallest share of the business among the three companies, but LS ELECTRIC differs in being able to supply the distribution equipment inside the data center as well.

Tariffs and Antidumping Duties: Terms for Selling Korean Transformers in the US

Korean companies selling transformers in the US face two trade measures. One is the Section 232 tariff under the Trade Expansion Act, which applies to steel, aluminum and copper derivative products. The other is the antidumping duty on Korean large transformers in place since 2012.

The Section 232 tariffs were revised in April 2026. From April 6, large transformers are subject to a temporary 15% through the end of 2027, and the rate returns to 25% on January 1, 2028 (Legal 500, Apr 8, 2026). Hankyung reported that the effective tariff on large transformers fell "from the high 20s to about 15%." Distribution transformers are reported to remain at 25%, so the tariff burden depends on which product a company sells.

Antidumping rates differ by company. The original 2012 determination was 29.04% for Hyosung, 14.95% for Hyundai Heavy Industries and 22% for others. In the 11th administrative review in August 2026 (imports since August 2023), HD Hyundai Electric and Iljin Electric received 0%, and LS ELECTRIC and Hyosung Heavy Industries received 4.32% (SBS Biz, Aug 13, 2026).

Transmission Lines and Cables: The Path Electricity Travels

If a transformer changes voltage, transmission lines and cables are the path the electricity travels. On land, most are overhead lines strung on towers, but underground and subsea cables are used to cross water or pass through cities. To send large amounts of power over long distances, high-voltage direct current (HVDC) transmission converts alternating current to direct current, and only a handful of companies can make these cables.

CompanyRoleLatest figuresSource
Hitachi Energy (Hitachi subsidiary, Japan)Transformers, HVDC, grid equipment$457 million large transformer plant in Virginia, completing in 2028Announced Sep 2025
Siemens Energy Grid TechnologiesTransformers, HVDC, switchgearSegment backlog of EUR 51 billion (end of June 2026)Fiscal 2026 Q3 results
GE VernovaGEV ElectrificationTransformers (Prolec GE), switchgear, grid software$40.6 billion equipment backlog (including $5.0 billion at Prolec GE)Q2 2026 results
Prysmian (Italy)Extra-high-voltage and subsea cablesCompleted acquisition of US-based Encore Wire in July 2024 ($290 per share)Company announcement
LS Cable & SystemHVDC subsea cables$682.7 million Virginia subsea cable plant, mass production in first half of 2028Korea Herald (Jun 25, 2026)
Taihan CableExtra-high-voltage cables, subsea cablesBacklog of KRW 4.0629 trillion (first time above KRW 4 trillion)Dailian (Jul 30, 2026)

Transmission investment is rising too. A US nonprofit, Powerlines, analyzed the earnings releases of 51 utilities and found that US investor-owned utilities plan at least $1.4 trillion of capital spending through 2030 (E&E News, Apr 15, 2026). In April 2025, Texas regulators approved the first 765 kV transmission line in the area run by grid operator ERCOT. In Korea, the National Assembly passed a special act to expand the national backbone power grid on February 27, 2025, and the plan is to build a west coast HVDC line (8 GW, about KRW 12 trillion) by 2038.

Limitations and Risks When Looking at Transformer and Transmission Companies

First, supply is increasing. Announced transformer capacity additions in North America since 2023 exceed $1.8 billion, and new facilities at Hitachi Energy (2028), Siemens Energy's US plant (early 2027), Eaton (2027), HD Hyundai Electric in Alabama (2027) and Hyosung Heavy Industries in Memphis (2028) start up in 2027-2028. Today's high prices and margins come from the shortage, so demand at the time the expansions finish needs to be checked separately.

Second, strong results and a stable share price are different things. All three companies reported record-level backlogs for Q2 2026, but on October 12 their shares were 59% (HD Hyundai Electric), 51% (Hyosung Heavy Industries) and 42% (LS ELECTRIC) below their closing highs of May 7. On January 31, 2025, the first trading day after the Lunar New Year holiday when the DeepSeek shock was first priced in, the three also fell 5% to 12% in a day.

Third, there are policy and cost variables. The 15% tariff on large transformers applies only through the end of 2027, and antidumping rates change with each review. A large part of revenue is concentrated in North America, so results depend heavily on US policy and utilities' investment plans, and copper and electrical steel prices feed directly into costs.

Checkpoints for Investors

  • Is the gap between backlog growth and revenue growth widening or narrowing?
  • Have you separated whether orders are for products with few suppliers, such as extra-high-voltage and 765 kV transformers, or for distribution products with more competition?
  • Do you know whether the operating margin staying in the 20% range rests on price, product mix or a one-time factor?
  • Have you checked the price outlook for after the US expansion facilities (2027-2028) start up?
  • Have you put the 2028 return of the Section 232 tariff and the antidumping review results on your calendar?
  • Have you recorded the share price reaction the day after earnings, to test whether expectations are running ahead of results?

Frequently Asked Questions

Q1. When will the transformer shortage ease?

There is no set date. In January 2026, Wood Mackenzie said long lead times and high prices will become "the new normal."

However, announced capacity additions in North America start up in 2027-2028, and some assessments say distribution transformer supply has improved since 2025. The pace at which the shortage eases differs between extra-high-voltage and step-up transformers and distribution transformers, so look at it separately for the product line a company sells.

Key Takeaways

  • Transmission and substations raise electricity to high voltage for transport and step it down in stages, and the key equipment is the transformer.
  • Lead times for large US transformers have stretched to two to five years, power transformer prices are up 77% since 2019, and 82% of the units installed in 2019 were imported.
  • HD Hyundai Electric (backlog of $8.490 billion) and Hyosung Heavy Industries (KRW 17.5 trillion) keep posting record results on North American extra-high-voltage and 765 kV transformer demand.
  • LS ELECTRIC is mainly a distribution company, but its extra-high-voltage transformer revenue grew 91% in Q2, and LS Cable & System, Taihan Cable and Prysmian receive grid investment through HVDC and subsea cables.
  • The 15% tariff on large transformers is temporary through the end of 2027, and antidumping rates by company range from 0% to 4.32%.
  • Despite record backlogs, the three stocks are 42% to 59% below their May 2026 peaks, so business visibility and share price stability need to be judged separately.

References

  • US Department of Energy (DOE), "Large Power Transformer Resilience Report to Congress" (Jul 2024)
  • POWER Magazine, Sonal C. Patel, "Transformers in 2026: Shortage, Scramble, or Self-Inflicted Crisis?" (Jan 2, 2026)
  • T&D World, "Report Warns of Worsening Transformer Shortages Amid Rising US Power Demand" (Aug 15, 2025)
  • Dealsite, report on HD Hyundai Electric's 2025 results (Feb 6, 2026); Finance Scope, report on HD Hyundai Electric's Q4 and North American backlog (Feb 2026)
  • Hankyung, report on HD Hyundai Electric's Q1 2026 results (Apr 28, 2026)
  • Asia Economy and Dailian, reports on HD Hyundai Electric's Q2 2026 results (Jul 28, 2026)
  • Korea Times, "HD Hyundai Electric expands US transformer manufacturing capacity" (Mar 8, 2026)
  • CEO Score Daily, report on HD Hyundai Electric's 765 kV transformer order (Sep 22, 2025)
  • Money Today, report on Hyosung Heavy Industries' 2025 results (Jan 30, 2026); Dailian, report on Hyosung Heavy Industries' Q2 2026 results (Jul 31, 2026)
  • Herald Business, report on Hyosung Heavy Industries' 765 kV order (Feb 9, 2026); Hankyung, report on the Hyosung Heavy Industries Memphis expansion and results (Aug 3, 2026)
  • Power Engineering, "Hyosung acquiring Memphis transformer plant from Mitsubishi Electric Power" (Dec 16, 2019)
  • SBS Biz, report on LS ELECTRIC's Q2 2026 results (Jul 23, 2026); Herald Business, report on LS ELECTRIC's second Busan extra-high-voltage transformer plant (Dec 3, 2025)
  • Legal 500, "The President Signs Proclamation Overhauling Section 232 Tariffs on Steel, Aluminum and Copper" (Apr 8, 2026)
  • SBS Biz, report on the 11th administrative review of antidumping duties on Korean transformers (Aug 13, 2026)
  • Plant Services and T&D World, reports on Hitachi Energy's South Boston plant investment (Sep 2025)
  • GE Vernova, Q2 2026 earnings release (SEC Form 8-K, Jul 22, 2026); Siemens Energy fiscal 2026 Q3 results (Aug 5, 2026)
  • Prysmian, announcement of completed Encore Wire acquisition (Jul 2, 2024)
  • Korea Herald, report on LS Cable & System's Virginia subsea cable plant (Jun 25, 2026); Dailian, report on Taihan Cable's Q2 2026 results (Jul 30, 2026)
  • E&E News, "US utilities planning record-breaking capital spending" (Apr 15, 2026)
  • T&D World, report on ERCOT's first 765 kV transmission line approval (Apr 28, 2025)
  • MTN, report on the National Assembly passing the special act to expand the national backbone power grid (Feb 27, 2025); Money Today, report on the west coast HVDC plan (Jul 10, 2025)
  • Hankyung, report on the DeepSeek shock sell-off in Korean power equipment stocks (Jan 31, 2025)
  • Stock prices: calculated on Yahoo Finance daily closing prices

For reference only: The information in this post is provided for general reference and does not constitute investment advice or a solicitation to trade. Your responsibility: Final investment decisions and their outcomes are entirely your own. No warranty: This information is not guaranteed to be accurate and cannot be used as a basis for legal liability for any investment result.

Trading review workflow

Turn this read into your next trading review

Capture the chart, thesis, mistakes, and next improvement in one review flow so the lesson stays usable.

Start a trading journal

Market context is provided for research and review, not personalized financial advice.
